Pune | EIA body defers green clearance for riverfront development project

Asks PMC to complete compliance with conditions.

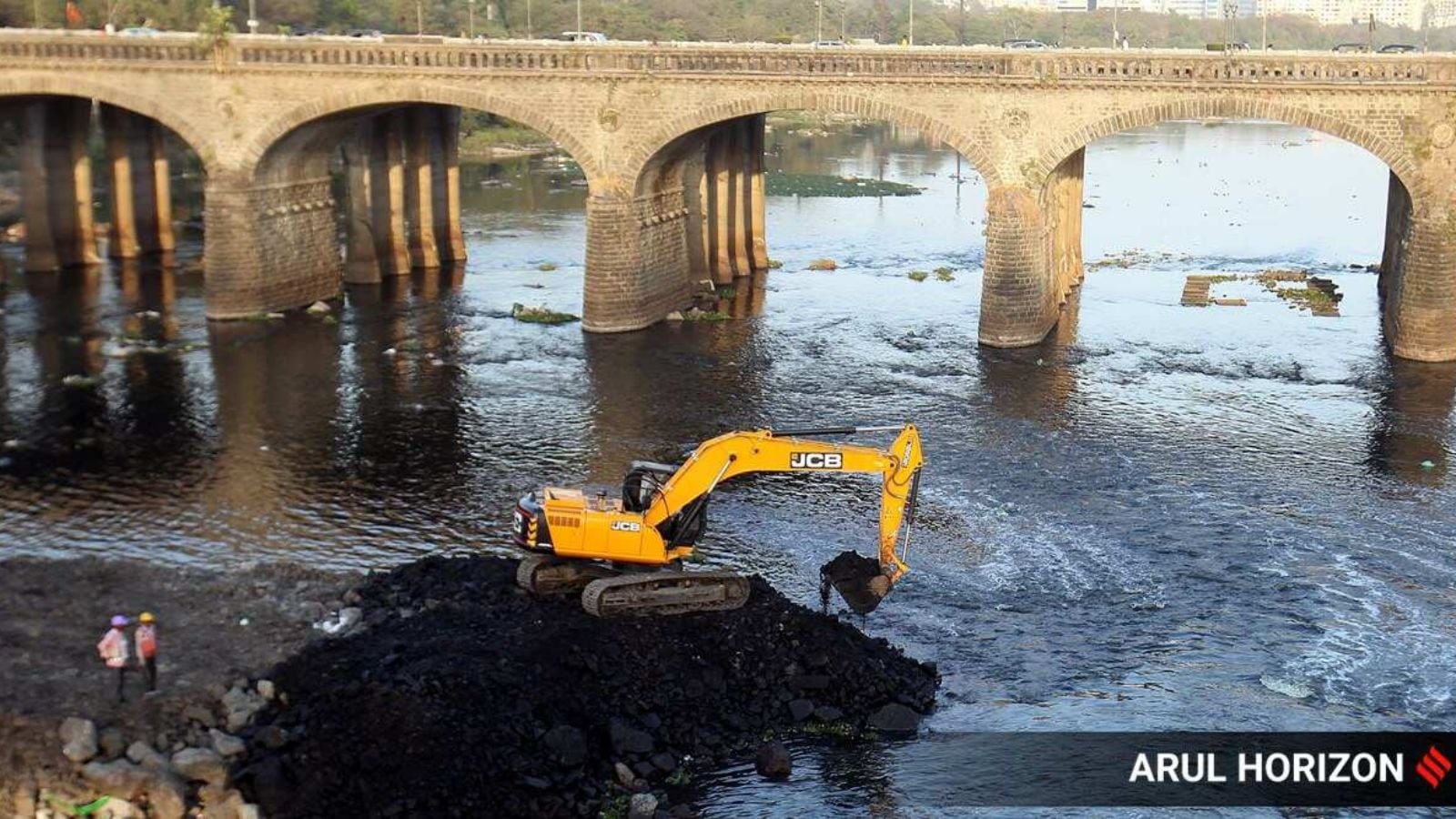

Pune riverfront projectThe RFD project includes the development of a 44-km river stretch, which includes 22.2 km of Mula river, 10.4 km of Mutha river and 11.8 km of Mula-Mutha river. The project is divided into multiple stretches for implementation and work has begun on two stretches. (Express file photo)

The State Environment Impact Assessment Authority (SEIAA) has deferred issuing Environment Clearance (EC) for the River Front Development (RFD) while asking the civic body to complete the compliance with the conditions laid by it.

The SEIAA also asked Central Water and Power Research Station (CWPRS) to specifically comment on whether after channelisation of river under the project would there be rise in river flooding events in Pune city.

The National Green Tribunal (NGT), in August last year, had directed the PMC to not to fell any tree for River Front Development (RFD) project till the SEIAA allows the amendment in Environment Clearance for the project proposed by the civic body.

Citizens Sarang Yadwadkar and Pushkar Kulkarni had filed an application in the NGT seeking directives to the PMC for prohibiting from tree felling for RFD alongside Mula, Mutha and Mula-Mutha river until a fresh appraisal of the project is conducted as per supreme court order of March 27 last year.

The RFD project includes the development of a 44-km river stretch, which includes 22.2 km of Mula river, 10.4 km of Mutha river and 11.8 km of Mula-Mutha river. The project is divided into multiple stretches for implementation and work has begun on two stretches.

According to the civic body’s proposal, a total of 7,539 trees will be affected of which 3,110 would be completely cut while 4,329 would be transplanted. The PMC will be planting 66,434 new trees to compensate for the cutting of trees.

In its minutes dated November 7 last year and issued on Monday, the SEIAA observed that the PMC should submit compliance of 18 requirements for getting EC for the project.

Story continues below this ad

It also asked the CWPRS to analyse the Hyrdaulic and Hydrology study and specifically comment on “whether after channelisation would there be rise in river flooding events in Pune city as well as Pluvial floods beyond both the banks of rivers, whether after channelisation as the confluence of Mula and Mutha river would there be rise in river flooding events, whether 100 years floods data has been considered while computing the flood levels.”

As one of the foremost objectives of the project is to reduce the risk of flooding, the SEIAA sought specific clarification on phase-wise targets and likely milestones about it while seeking confirmation of Indian standard codes for all works including embarkments.

“Whether the TERI report on climate change scenario of 37.5 per cent rise in annual rainfall with reduced number of rainy days, more frequent cloud bursts, considered.”

It asked the PMC to submit details of all existing structures to be retained or demolished, built up area as well as construction area to include all construction including retaining walls.

Story continues below this ad

“The SEIAA observations are very crucial and substantiates our stand on dangers of the project to environment and human life. It has asked PMC to do compliance of the laid conditions and we feel it is scientifically impossible for the civic body to comply them,” said Yadwadkar.

“It is the moral responsibility of PMC to stop the ongoing work on three of the 11 stretches being developed under the project. We will take up the issue at the relevant forum if the PMC does not stop the work immediately,” he added.
City Engineer Prashant Waghmare, however, said, “The SEIAA has sought details on compliance by PMC for implementing the RFD and deferred decision till then. We will submit the compliance and soon get EC for project.”

The work on three stretches is being done, he said adding the PMC is prepared to start work on other eight stretches once it gets EC for the project.
