Premium

How one advertisement hoarding held up Mumbai’s crucial Metro Line 5 for three years — Not anymore

A 30-by-40-foot hoarding, nearly five storeys tall, stood squarely in the path of Mumbai Metro Line 5, which is the corridor linking Thane, Bhiwandi and Kalyan. Read on to find out how it was finally brought down.

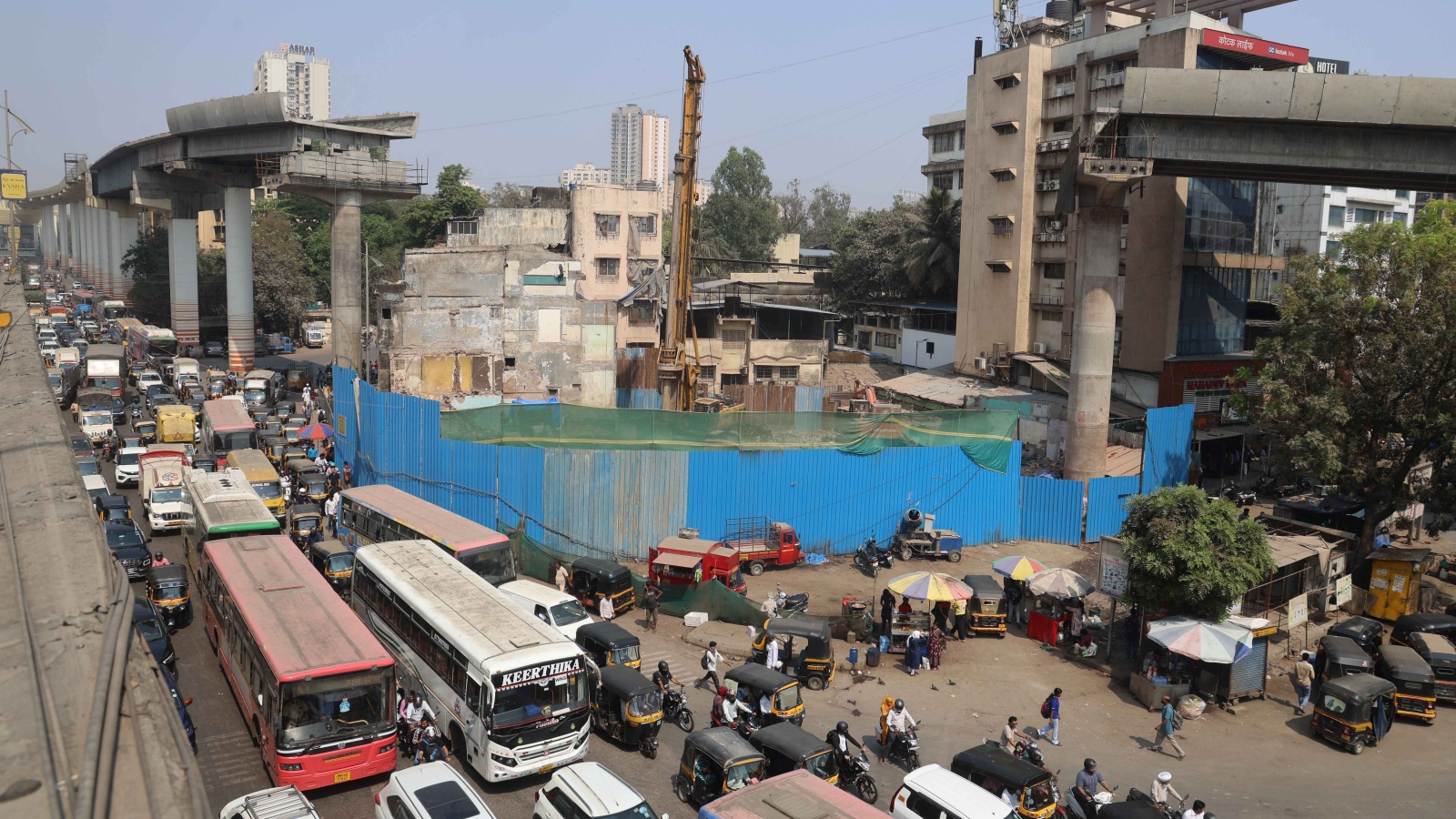

Mumbai Metro Line 5, Mumbai Metro Line 5, Kapurbawdi Junction, Thane, How one hoarding held up Metro Line 5, Metro Line 5, MMRDA, Mumbai Metropolitan Region Development Authority, Indian express news, current affairsAt present, commuters travelling between Thane and Bhiwandi rely largely on shared auto rickshaws charging Rs 40 to Rs 50, with travel times ranging from 45 minutes to over an hour during peak periods. Once operational, the 12-km journey is expected to take around 25 minutes. (credit Deepak Joshi)

For nearly three years, a five-storey-high advertising hoarding at Kapurbawdi Junction in Thane managed to do what traffic, funding crunches and land acquisition battles often cannot — hold up an entire Metro line.

This month, it finally came down.

In mid-February, the Mumbai Metropolitan Region Development Authority (MMRDA) dismantled the 30-by-40-foot hoarding and demolished three adjoining buildings, clearing the way for work on the last pending pier of Mumbai Metro Line 5’s first phase. With that, the final physical obstacle to completing the Thane–Bhiwandi–Kalyan corridor has been removed.

The obstruction had stalled construction of Pier 14, even though 97 per cent of the viaduct work had already been completed by early 2025. Officials said the impasse delayed Phase 1 of the project by at least a year.

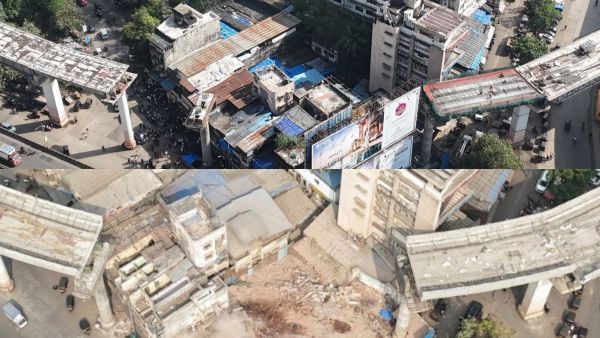

Mumbai Metro Line 5, Mumbai Metro Line 5, Kapurbawdi Junction, Thane, How one hoarding held up Metro Line 5, Metro Line 5, MMRDA, Mumbai Metropolitan Region Development Authority, Indian express news, current affairs Before and After (credit: Indian Express)

Metro Line 5, currently under construction, will connect Thane, Bhiwandi and Kalyan and is expected to significantly ease travel to Bhiwandi, a fast-growing logistics, warehousing and data centre hub.

The hoarding — nearly five storeys high — stood directly in the alignment of the elevated corridor at Kapurbawdi, one of Thane’s busiest junctions. Alongside it were the Mahalaxmi Building, Mahavir Building, Jain House and the adjoining Sun City Bar, housing around 40 residential occupants and 29 commercial establishments.

Since 2022, the MMRDA had been negotiating compensation with landowners and occupants while repeatedly urging the Thane Municipal Corporation (TMC) to dismantle the hoarding. The issue was escalated to the Chief Minister’s War Room in 2024.

Officials said much of the land belongs to former Thane mayor Harishchandra Patil. An official said work on the only pending pier was obstructed by the hoarding and three buildings and that convincing owners and occupants at such a prime location took time.

Story continues below this ad

According to MMRDA officials, incomplete land ownership documentation complicated compensation for the structures, hoarding and private land, amounting to around Rs 22 crore. As per the Land Acquisition, Rehabilitation and Resettlement Act, 2013, the compensation amount was deposited with the district collector to be disbursed once eligibility is established.

Officials said that for occupants, demolition meant losing prime property without compensation immediately in hand. While the Project Affected Persons (PAPs) have been rehabilitated and handed over alternate homes and commercial units, the cash component of the rehabilitation is yet to be received by these PAPs. Commercial units have been rehabilitated within Kapurbawdi, while residential occupants have been shifted to Balkum in Thane.

Apart from the buildings, the hoarding itself became a flashpoint. Officials said work could not proceed unless it was dismantled.

They alleged that the Thane Municipal Corporation did not act until December 2025, when a joint demolition plan was finalised. Even after permissions were revoked, the vendor allegedly continued to use the structure in January 2026.

Story continues below this ad

A senior official from the TMC acknowledged the long-standing tussle. “The MMRDA was offering remuneration to the private landowner on which the hoarding and buildings stood on, but issues arose,” the official said. However, the official was not aware of the status of the permissions given to the hoarding. Another TMC official said, “The issue took a while but now it has been resolved by TMC and MMRDA.”

Vicky Patil, son of Harishchandra Patil, said delays were largely due to compensation and rehabilitation concerns. He said that by July the buildings were emptied and the process for land compensation was underway.

With the bottleneck cleared, the MMRDA is targeting a partial opening of Metro Line 5 by the end of 2026.

Bombay High Court allows partial relief to MMRDA in Mumbai Metro-1 dispute with MMOPL

The first operational stretch is expected to cover six stations between Balkum Naka and Dhamankar Naka in Bhiwandi. Kapurbawdi will serve as an interchange with Metro Line 4, which is slated to open earlier.

Story continues below this ad

At present, commuters travelling between Thane and Bhiwandi rely largely on shared auto rickshaws charging Rs 40 to Rs 50, with travel times ranging from 45 minutes to over an hour during peak periods. Once operational, the 12-km journey is expected to take around 25 minutes.

Sabah Virani is a journalist with The Indian Express’ Mumbai bureau, covering infrastructure, housing and urban issues. In the realms of technical fields, she brings out human stories and the pace of change ongoing in the city. Expertise Specialised Role: Tracking infrastructure in Mumbai and the wider Mumbai Metropolitan Region (MMR), Sabah’s reporting tracks progress on various projects. From bridges to metros, she mixes technical details with resourceful information. Core coverage areas: Sabah keeps a close eye on the activities of the Mumbai Metropolitan Region Development Authority (MMRDA) and its projects across the MMR, including the metros, road projects, bridges, the bullet train, pod taxi, its role as a planning authority, and more. She also watches for developments from the Maharashtra State Road Development Corporation (MSRDC), City and Industrial Development Corporation of Maharashtra (CIDCO) and the GoM’s Urban Development department. Housing: Sabah also tracks developments in housing, particularly the workings of the Slum Rehabilitation Authority (SRA). She also keeps a keen watch on the big redevelopment projects ongoing in Mumbai, including the Dharavi Redevelopment Project, Motilal Nagar, Kamathipura, BDD Chawl redevelopment, among others. Occasionally, she reports on the environment, biodiversity, waste, arts and culture. Experience: Prior to working for the Indian Express, Sabah covered the municipality, civic issues and miscellaneous for Hindustan Times. Before that, she covered all things Mumbai for the online publication Citizen Matters. She has also worked as an editorial assistant at FiftyTwo.in.   ... Read More
