Gujarat finds ‘should be 90% done’ flyovers are at 40%. And have rusted steel

Two engineers suspended in Gujarat’s Rajkot; Deputy Commissioner and Executive Engineer get show cause notices

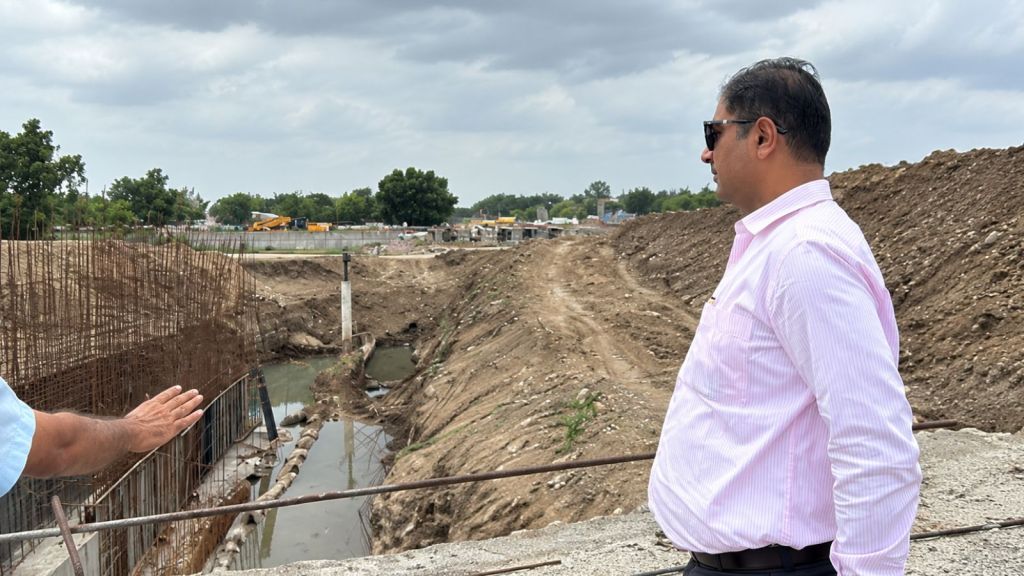

Rajkot flyovers. Rajkot flyover delay, Rajkot flyover construction, Rajkot flyover work, Rajkot Municipal Corporation, RR-2 flyovers, rusted steel rebars, flyover poor workmanship, Rajkot civic body, BR-2 flyover, BR-3 flyover, BR-4 flyover, Gujarat infrastructure projects, Rajkot news, Indian Express newsRajkot Municipal Commissioner Tushar Sumera said his inspection had uncovered several concerns. (Express Photo)

Shoddy workmanship and delay in construction prompted the civic body in Gujarat’s Rajkot to suspend two engineering officials and issue show-cause notices to two senior supervisory officers overseeing three flyovers being built in the largest city in the Saurashtra region.

The move came after a report by the Project Management Unit (PMU), set up by the Municipal Commissioner Tushar Sumera to investigate the delay in construction, flagged defects and rusted steel rebars, apart from the slow pace of construction of the three flyovers located in Phase-I of the RR-2, between the Jamnagar road and Kalavad road intersections.

The three flyovers — BR-2, BR-3 and BR-4 — are part of the ongoing expansion of the two-lane Phase-I stretch of RR-2 into a four-lane road, along with additional infrastructure. The original two-lane section was completed in 2016. The three flyovers together have an estimated project cost of around Rs 40 crore.

Following the findings and an on-site inspection by Sumera on September 7, the civic body suspended Deputy Executive Engineer (Civil), Ward No. 9, Vijay C Kariya, and Assistant Engineer (Civil), West Zone, Vishal M Vagadia.

“The survey report filed by the PMU found shortcomings in the work of three bridges. Due to the clear lack of workmanship in the work and serious negligence, laxity and carelessness towards duty, Kariya and Vagadia were suspended from their duties,” the civic body said in a statement.

In addition, the civic body issued show-cause notices to Deputy Municipal Commissioner of West Zone Chetan Nandani and Executive City Engineer Kuntesh Mehta.

An inspection and probe

This action came after an on-site review conducted by Sumera on September 7, in light of the PMU survey. Accountability, however, was not limited to those overseeing the project.

Story continues below this ad

Speaking to The Indian Express, Sumera said the inspection had uncovered several concerns. “The steel used in the construction was found to be rusted, which means proper care has not been taken. Further, there are spacing issues in the placement of the steel,” he said.

He added that the project was significantly behind schedule. “The work should have reached 90 per cent completion by now, but it has barely reached 40 per cent. The timeline has not been followed, and quality has not been followed, and such compromise cannot be allowed in such structures,” Sumera said.

According to the Commissioner, the PMU was set up after the delay in construction came to his notice. Its survey subsequently found that the problem went beyond delays. “Apart from the delay, even the quality is an issue. So I visited the sites, and then took action,” he said.

A detailed investigation is now expected to follow. Sumera said the Vigilance Department would probe the project and determine whether any portions need to be demolished. He said notices would also be issued wherever corrective work is required.

Story continues below this ad

The contractor will also be held accountable, Sumera said. “We will also be issuing notice to the contractor company, which is bound to give us quality work as per the tender protocols.”

In October 2025, The Indian Express published a report on the condition of the RR-2, its shortfalls, and the need for upgrades to meet the burgeoning population and connectivity needs of Western Gujarat.
